Storm Repairs 2014 - Shore Road towards Branksome beach

Project Diary: November

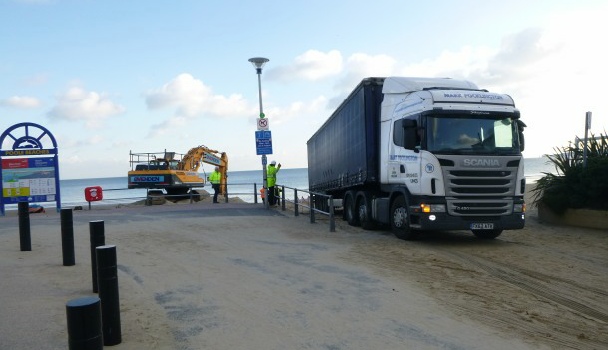

The contract has been let to Rohde Nielsen of Denmark - www.rohde-nielsen.dk/en

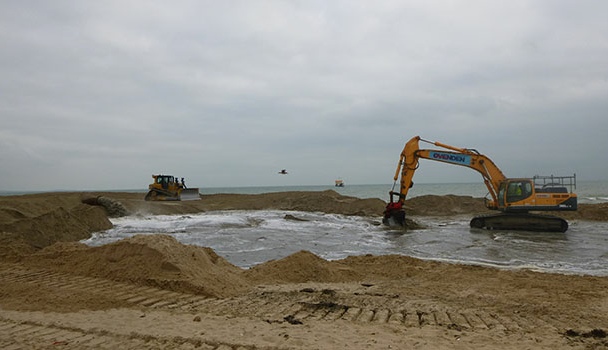

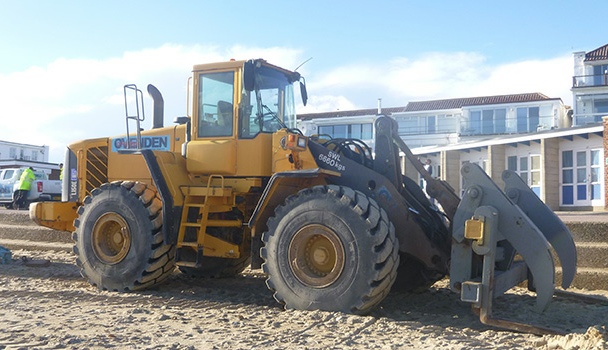

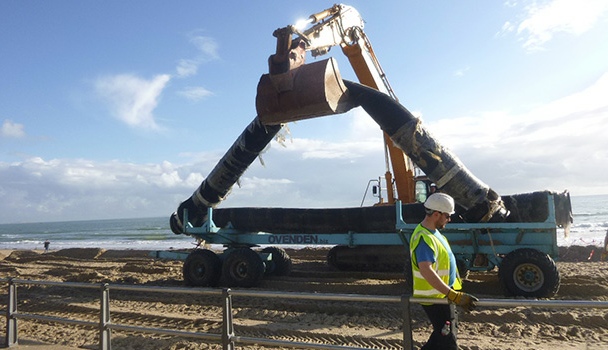

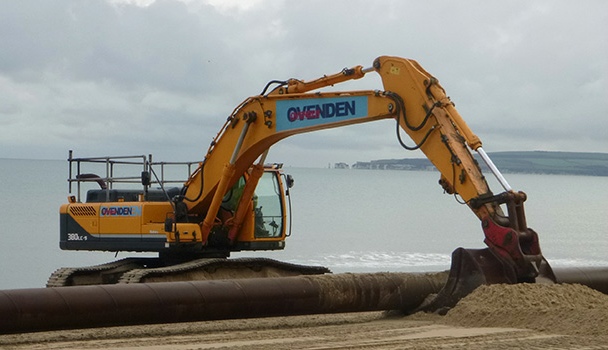

Day 2  The large land-based equipment starts to arrive ready for work

Click for a larger image

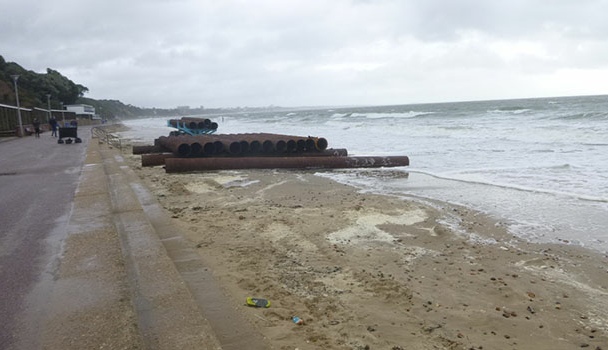

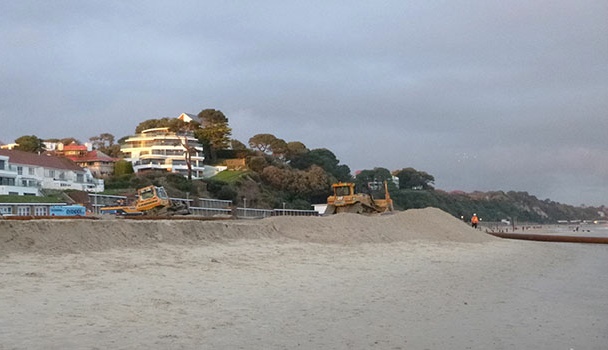

Day 1  High tide this morning illustrates the need for beach replenishment

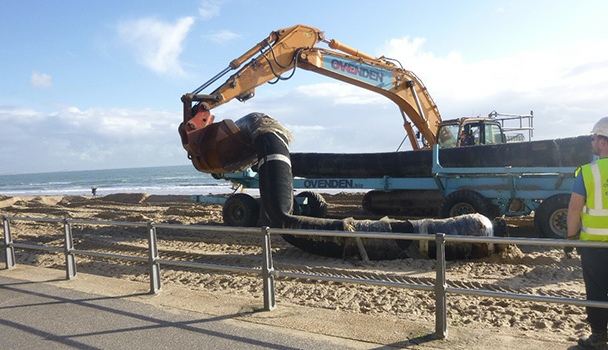

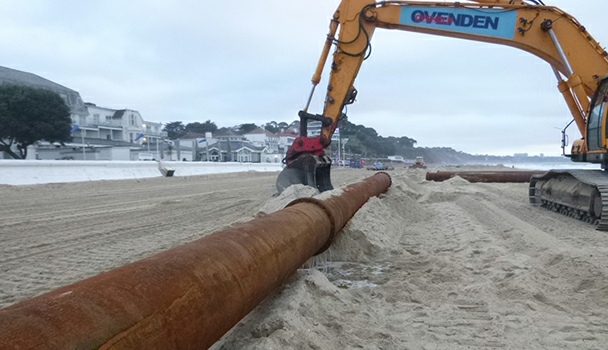

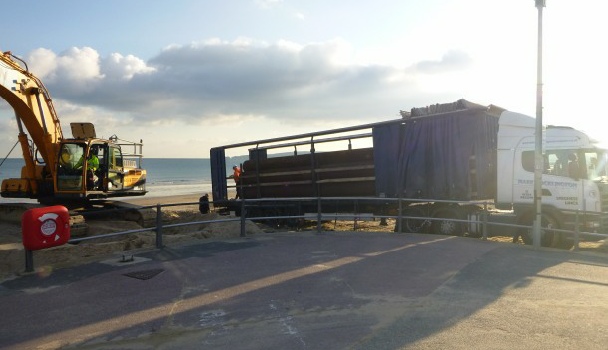

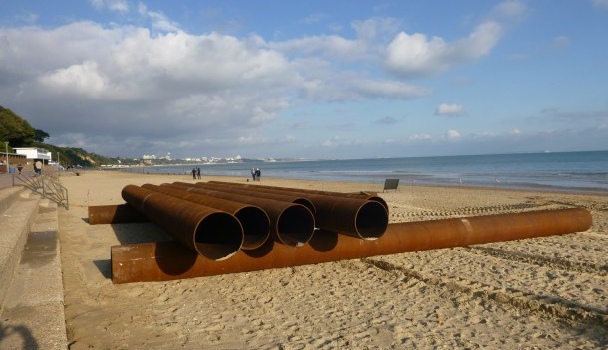

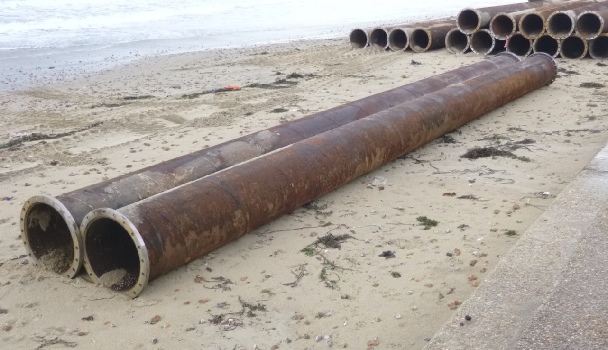

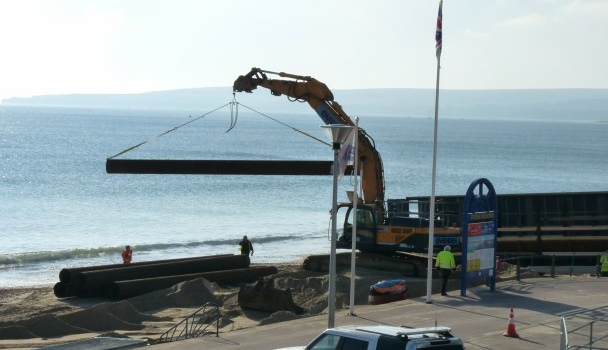

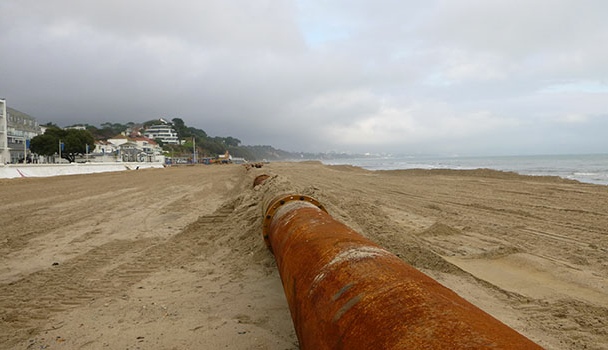

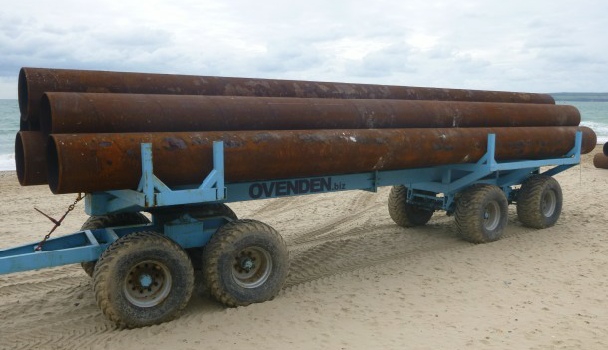

Day 3  12m sections of pipe for the sinkerline are delivered to the beach and stored ready for welding

WEEK ONE starting Monday 03 November

Tuesday 04 November

Wednesday 05 & Thursday 06 November

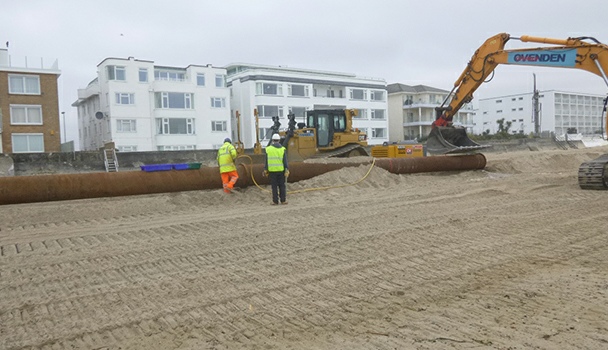

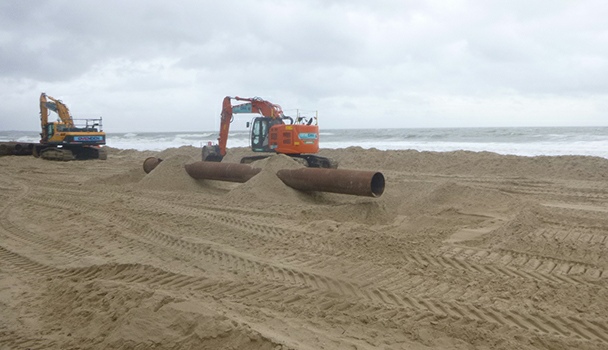

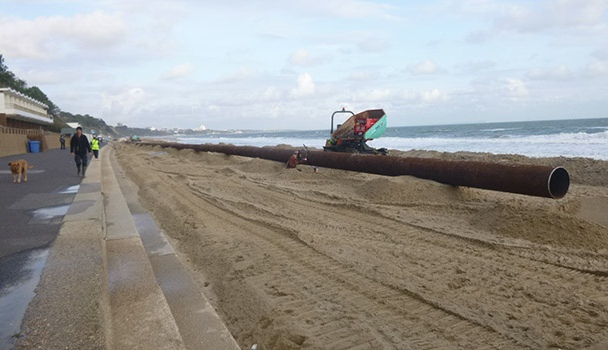

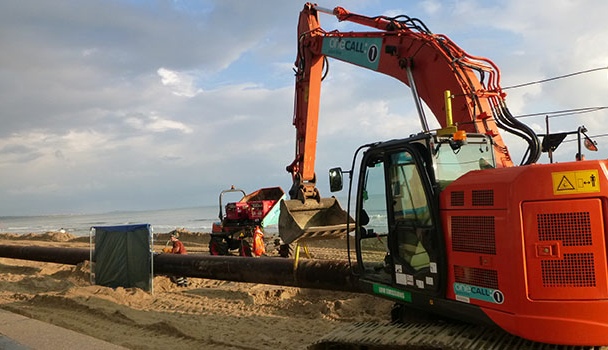

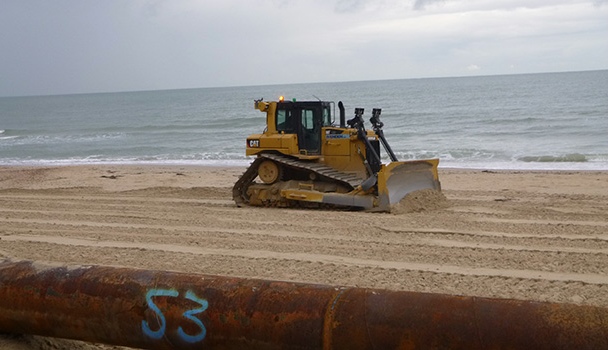

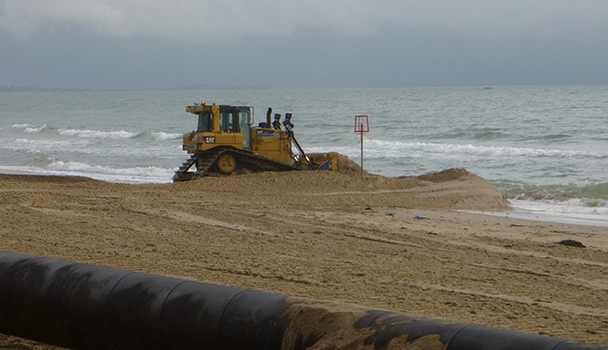

Day 5  Preparing a flat ‘platform’ as a working area for welding the pipes for the sinkerline

Friday 07 & Saturday 08 November

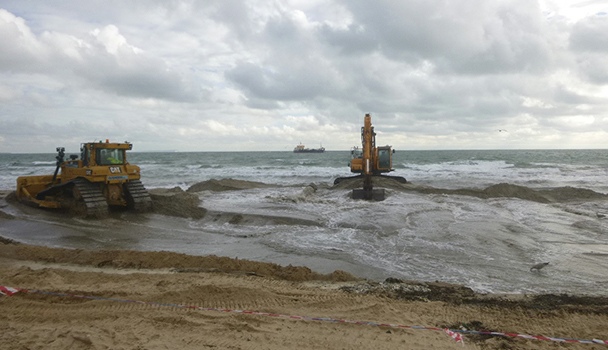

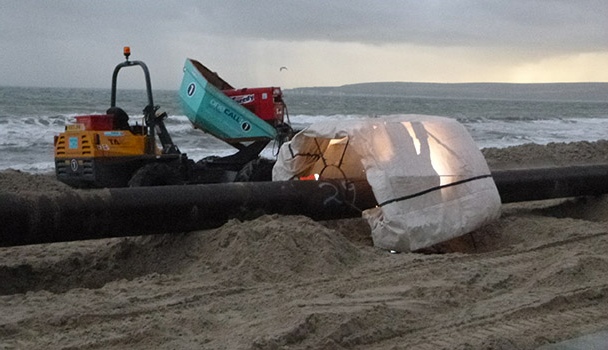

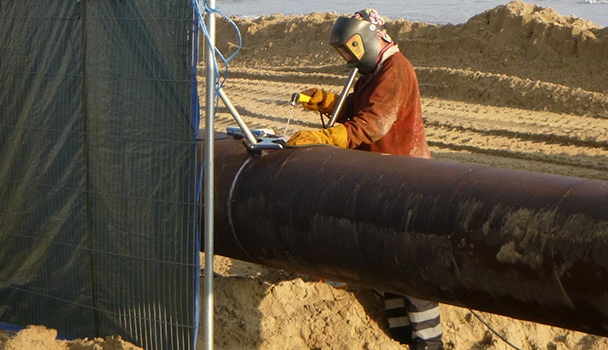

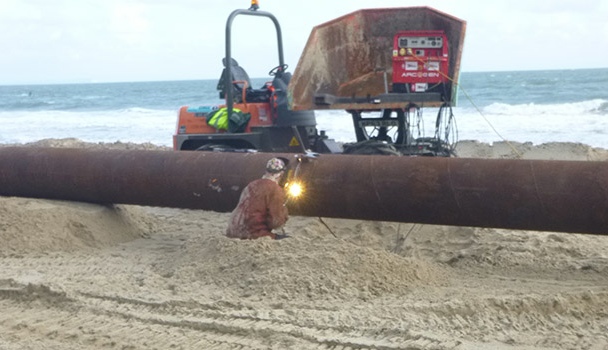

Day 7  A beautiful sunny day at the beach - pipe welding has begun

Sunday 09 November

Day 9  The sinkerline continues to grow - there are now 3 teams of welders on site

Tuesday 11 November

Short videos from the beach team

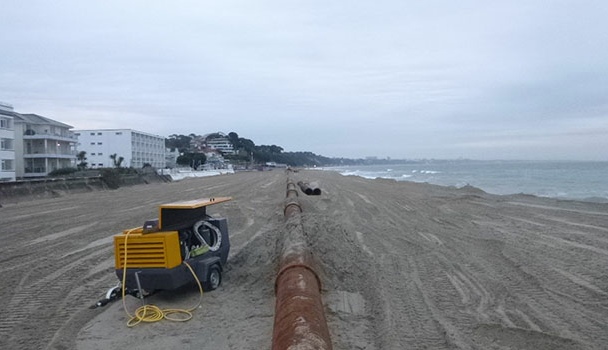

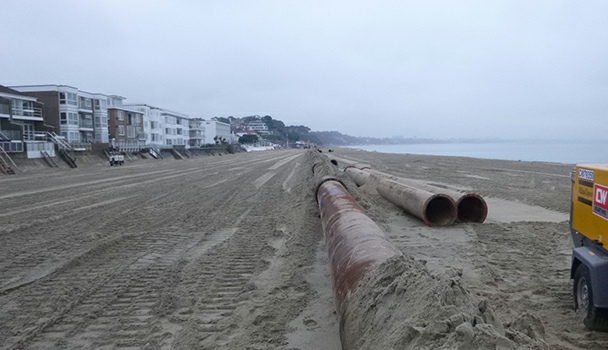

Day 11  Pipe No 45 - that totals 540m of the eventual 700m of sinkerline now completed

Wednesday 12 & Thursday 13 November

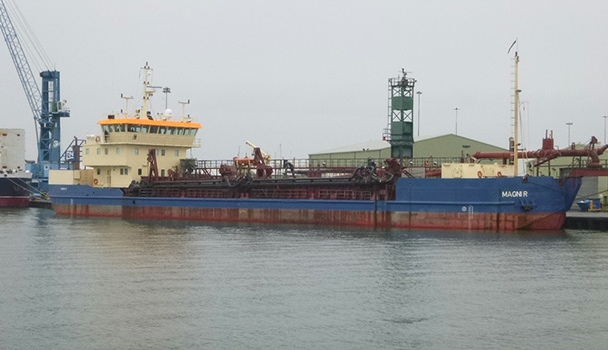

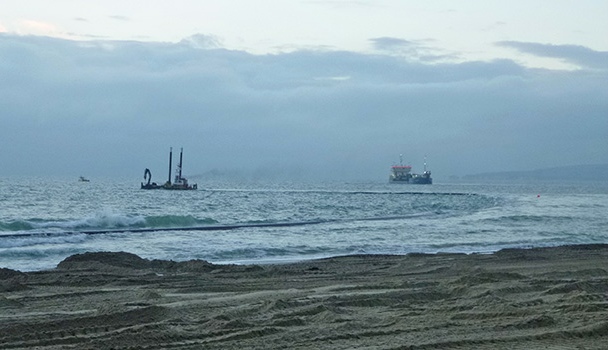

Day 14  The dredger MAGNI R in Poole Harbour

Over the weekend 15 & 16 November

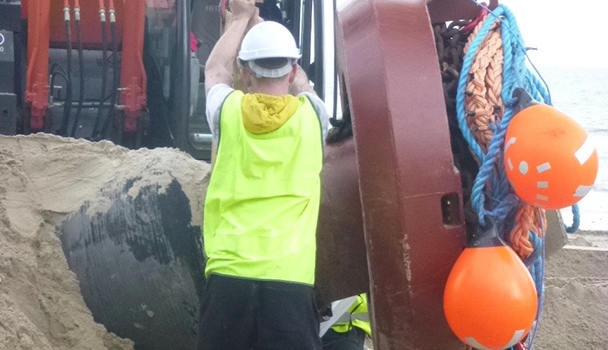

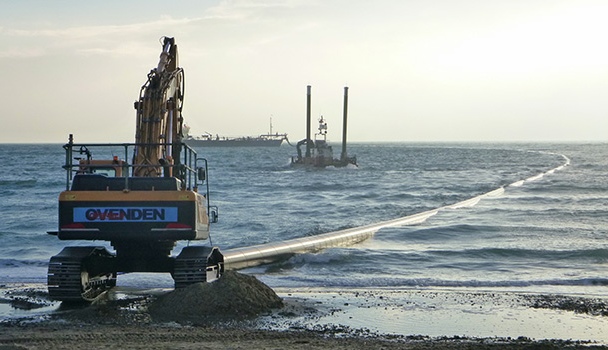

Day 15  The pipe is gently eased down the beach in preparation for tomorrow’s launch to sea

Monday 17 & Tuesday 18 November

/poolebeaches at Facebook @poolebeaches

Our colleagues at Sandbanks Beach Office also post regular project updates to their new Facebook & Twitter pages:

Get updates via Facebook or Twitter

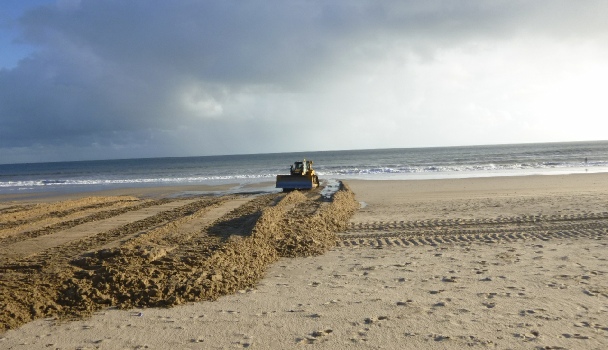

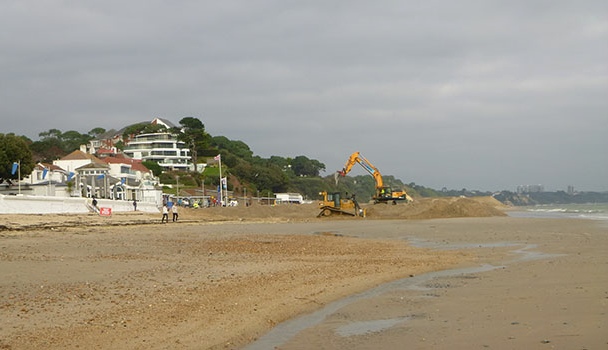

The area of beach to be replenished

Short videos from the beach team

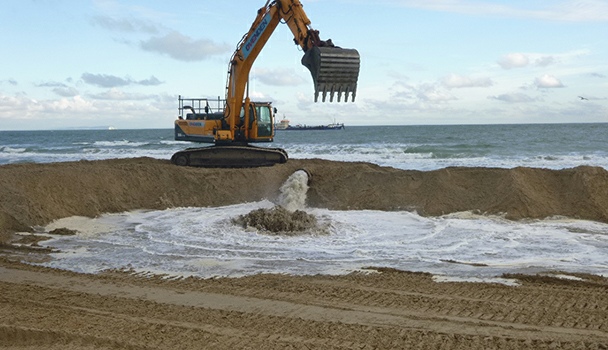

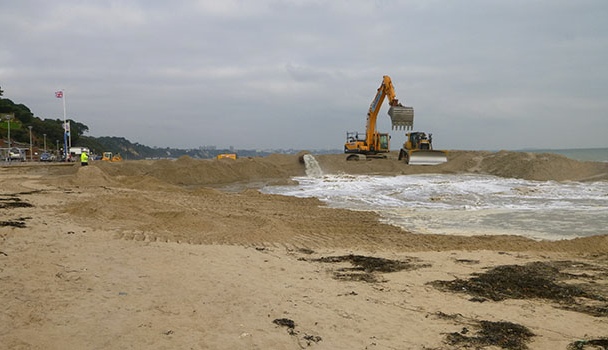

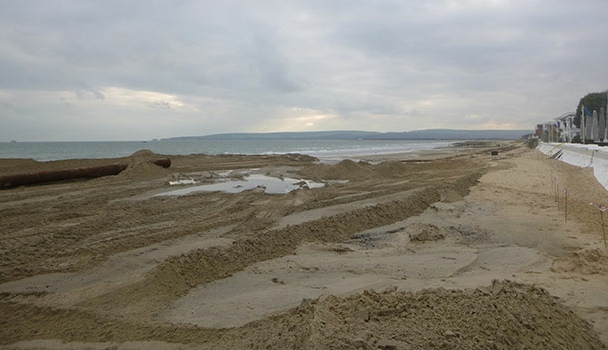

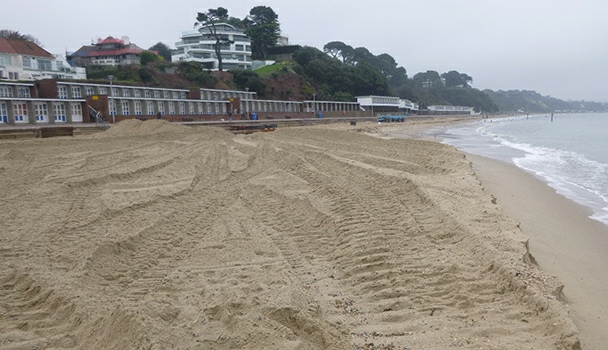

The beach is made up to a specified level and out to a specified width. The beach is being made out 50m from the seawall. In the first few weeks small ledges or cliffs were cut into the front of the beach by wave action as it sorted the new material, but these soon disappeared as the sand was moved by wind and waves into a natural beach profile.

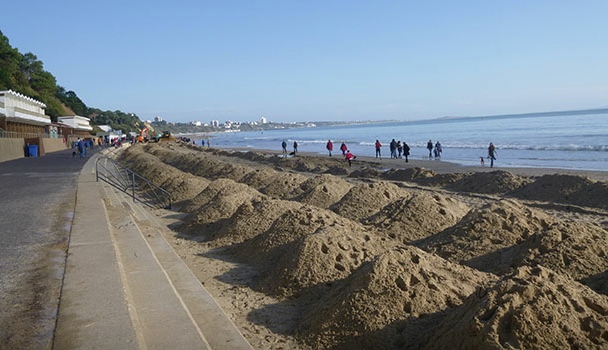

The crestline of the new beach as it’s shaped by wave action, 25th November

These videos and more at Poole’s FCERM* video channel www.vimeo.com/user34272790


* Flood and Coastal Erosion Risk Management

Project videos at vimeo.com/user34272790

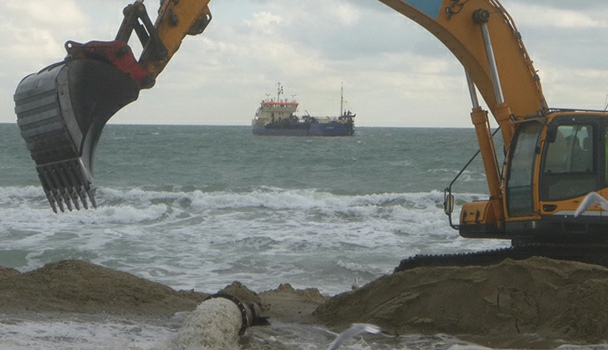

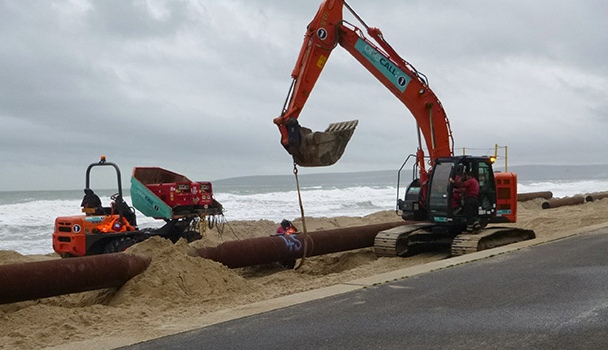

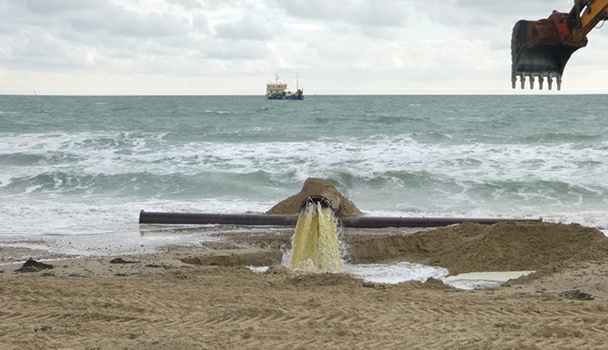

Day 17  The first load of sand (mixed with a large quantity of water) is pumped ashore by the dredger

Wednesday 19 November

Day 19  Eight loads of sand were pumped ashore today

Thursday 20 November

Click for a larger image

Check up on the current location of the dredger at www.marinetraffic.com

Track the MAGNI R

Days 20 & 21  All quiet at the beach, awaiting a spare part for the dredger (23 loads delivered so far)

Friday 21 & Saturday 22 November

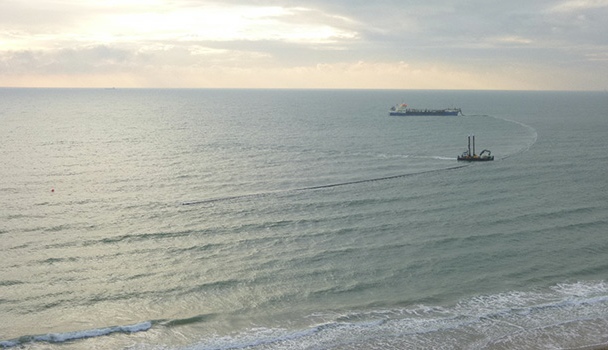

Days 23 & 24  The dredger is fixed; replenishment reaches the first combination groyne at Sandbanks

Monday 24 & Tuesday 25 November

The bund wall is now substantial. The dredger in the background can be seen connected to the flexible section of pipe. The pupming of the load from the dredger takes around 45 minutes

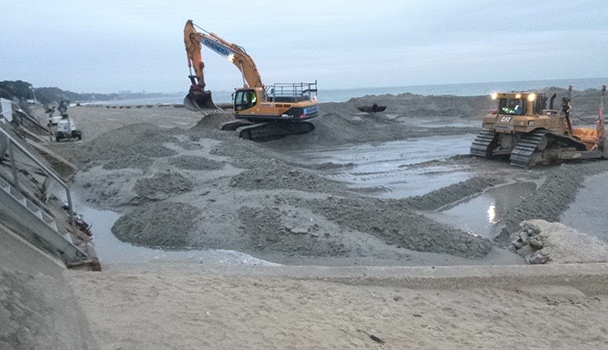

Bund creation part 1

Following the bund creation the sand material accumulates within the pond/pool and settles out, building the beach up to level.

Bund creation part 2

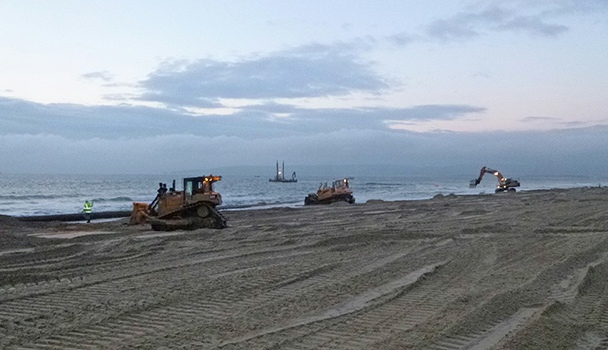

Working 24 hours, 7 days a week how the project continues after dark, 27th November

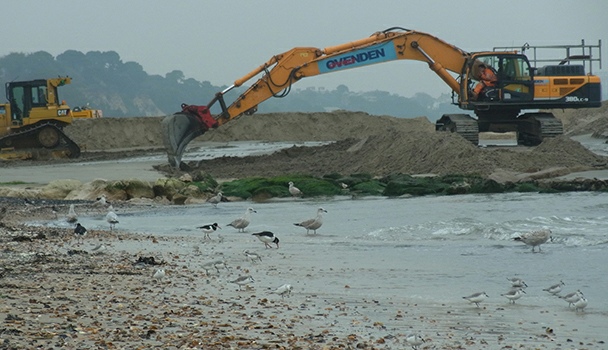

Day 25  Each pump attracts an attentive audience of Gulls, Oystercatchers and Sanderlings

Wednesday 26 - Friday 28 November

Now additional funding has been awarded, this area will be extended eastwards towards Branksome beach
